Construction HSE management that won't issue an unsafe permit

BuildCore holds a permit to work until its safety checks pass, won't close a serious incident without a completed investigation, and won't let the person who completed a corrective action verify it. TRIR, LTIFR and severity rate are worked out from the man-hours you record.

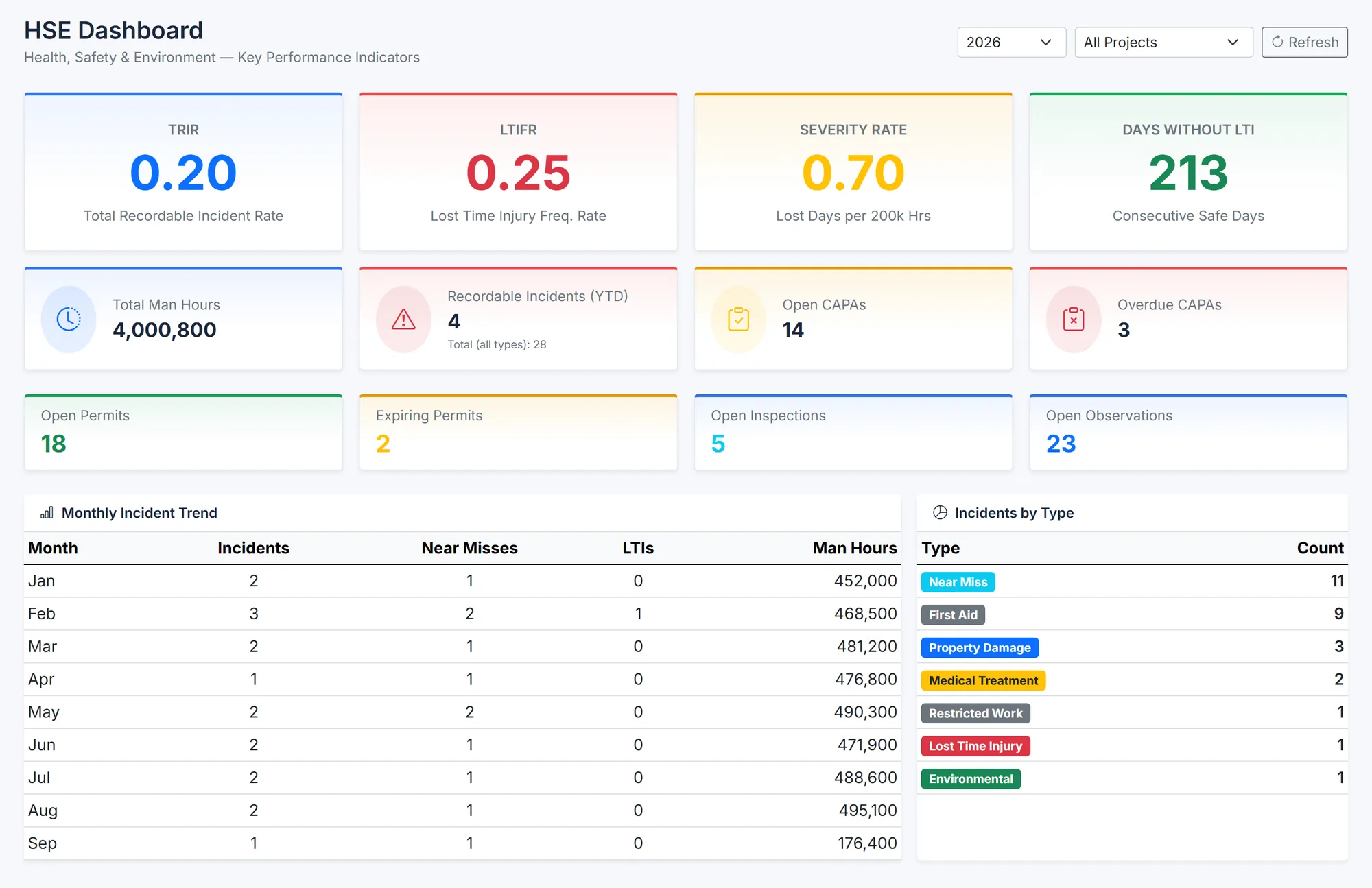

BuildCore's HSE dashboard: TRIR 0.20, LTIFR 0.25, severity rate 0.70 and 213 days without a lost-time injury; 4,000,800 man-hours, 4 recordable incidents, 14 open and 3 overdue corrective actions; 18 open permits, 2 expiring, 5 open inspections and 23 open observations; a monthly table of incidents, near misses, LTIs and man-hours; and incidents by type.
Frequency rates worked out from man-hours, with permits, inspections and the monthly trend. Sample data.
Why it matters

Safety systems fail at the signature

Most HSE failures aren't missing forms. They're forms signed before the check was done.

Permits signed on trust

A hot-work permit issued before the gas test, or a confined-space entry without isolation, is a paper control with no control in it.

Incidents closed without a cause

When an incident can be closed before it's investigated, the same incident comes back.

KPIs rebuilt every month

Frequency rates assembled in spreadsheets from scattered man-hours are late, and hard to defend to an auditor.

Capabilities

What HSE does

Permit to work

  • Permit types including hot work, cold work, confined space, work at height, excavation, electrical isolation (LOTO), lifting, line breaking and radiography
  • Each type carries its required checks — gas test, isolation, fall protection, certification — with sensible defaults
  • Issue is blocked until they pass: a satisfactory gas test within 30 minutes, isolation applied, fall protection with a rescue plan, a current certification
  • Gas tests record O₂, LEL, H₂S and CO; lock and tag numbers are recorded, and a permit can't close while an isolation is still applied
  • The raiser can't approve their own permit

Incidents, investigation and CAPA

  • Incidents numbered per project, with lost days, body part affected and photos
  • Structured 5-Why investigations — immediate, underlying and root causes, failed controls, lessons learned
  • An investigation can't be completed without a root cause
  • Lost-time, medical-treatment, restricted-work, major and critical incidents can't close without a completed investigation
  • Corrective actions completed, then verified by someone else, with overdue actions flagged

Measurement

  • TRIR, LTIFR, severity rate and near-miss frequency, from man-hours entered by project and month
  • Observation rate, training and permit compliance, and days without a lost-time injury
  • Contractor prequalification with expiry, and monthly scorecards scored 0–100 from the counts entered
  • An action centre and a nightly email digest of overdue actions, expiring permits and uninvestigated incidents

Programmes and registers

  • Observations — unsafe act, unsafe condition or positive — with category and risk level
  • HSE inspections with findings and a compliance score; an inspection can't close with a finding open
  • Risk assessments (HIRA, JSA, Take-5) scored before and after controls, with submit and approve
  • Toolbox talks with an attendee register, and emergency drills with lessons learned
  • Chemicals with SDS flags, medical fitness, journeys, management of change, environmental readings flagged over the limit, security incidents
How it works

A permit to work, check by check

1

Raise

The permit is drafted for the job and the location.

2

Approve

By someone other than the person who raised it.

3

Check

Gas test, isolation, fall protection and certification, as the type needs.

4

Issue

Only once the checks pass; the permit holder is notified.

5

Work

Isolations stay applied and on record.

6

Close

Only once every lock and tag has been removed.

Outputs

What comes out of it

  • Printable forms for all 16 HSE registers, with signature lines
  • A nightly email digest to HSE managers; permit and corrective-action notifications in the app
Questions

HSE & Safety — common questions

Not for a permit type that requires one. BuildCore blocks issue until there is a satisfactory gas test from the last 30 minutes, and likewise for isolation, fall protection and certification where the type needs them.

From the man-hours you record by project and month: TRIR per 200,000 hours and LTIFR per 1,000,000, alongside severity rate and near-miss frequency. Future months can't be entered, and edits are audited.

No. Lost-time, medical-treatment, restricted-work, major and critical incidents need a completed investigation — and an investigation needs a root cause.

Yes. Contractors are prequalified with an expiry date and get a monthly scorecard from 0 to 100, calculated from the figures entered.
